Demand Management Stage Gates: From Intake to Portfolio Decisions
Why Intake Chaos Hurts
Most PMOs start with good intentions: capture ideas, evaluate them, pick the best. But without structure, intake becomes a flood. Urgent requests bypass strategy. Governance turns political. The result? A portfolio that’s reactive, not strategic.
Stage gates bring structure to intake, but their value should not stop at approval. They create a transparent, documented path from idea to commitment and through later checkpoints, where leaders can revalidate benefits, consider capacity and decide whether to release further funding.
What are Stage Gates in Demand Management?
Stage Gates are checkpoints in your intake process where ideas are reviewed against agreed criteria before moving forward:
- Control flow (prevent overload)
- Enforce governance (reduce politics)
- Support compliance (check-list of must have data & approvals)
- Improve data quality (so decisions aren’t guesswork)
- Control funding (to reduce risk of waste)
This makes Stage Gates a mix of data collection, formal sign-off and best practice, the concept being that by having them integrated into one process it provides transparency and consistency without duplication.
Ideation: The Bedrock of Demand Management
Your best ideas often live on the frontline, where savings, process fixes, and customer “hacks” show up first:
- Make ideation effortless: one simple, always-on intake form anyone can use.
- Remove fear of “bad ideas”: lightweight capture, quick triage, fast feedback loop.
- AI assist: De-duplicate ideas, cluster themes, and draft summaries for different audiences.
- Communicate the strategy: “We need to save” / “We need to grow” / “We need to accelerate” – make it a challenge to solve with collective energy.
A well-structured Demand Management process is a funnel for ideas. By having a good process for prioritization, it means you can broaden the intake process at the top because you can handle the incoming demand effectively.
A Practical Stage-Gate Model
Stage gates must be customised with the right terminology and the right steps, but there are themes we recommend as a place to start:
Gate 0: Ideation
- Goal: Get ideas in quickly with minimal friction.
- Inputs: Short description, sponsor, rough benefit.
- AI assist: Auto de-dupe, tag by theme, suggest similar ideas.
Gate 1: Initiation
- Goal: Quickly process incoming projects for maximum efficiency.
- Inputs: High level AHP scoring for strategic alignment, plus an initial view of risk and readiness, to filter out weak proposals or ideas that are not ready for detailed review. Key for building stakeholder engagement early in the proposal.
- Triage: Give urgent requirements a defined fast track (e.g. Eisenhower Matrix), and flag mandatory work for a “Gate Lite” route directly to Gate 3, so they are still counted against capacity and pass through resourcing and sign-off at Gate 3 rather than bypassing the process.
Gate 2: Business Case
- Goal: Build forecasts for projects, to estimate costs, resource requirements and benefits, alongside risk assessment and mitigations.
- Method: Validate AHP model scores with reference to specific benefits in the business case. Forecast resource using templates, or high-level estimates.
- Constraint Based Planning: Compare scenarios against available funding and resource limits. Identify projects to progress for the next round of detailed planning.
Gate 3: Planning & Commitment
- Goal: Progress projects to Work in Progress and get going.
- Resourcing: Build out detailed Work Breakdown & allocate named resources.
- Governance: Portfolio board signs off, sponsors commit to benefits case.
- Funding: Release initial funds for discovery work, but only fully sign off after full planning.
Gate 4: Execution Control
- Goal: Escalate challenges via status updates and risk register. Track benefits confidence and key milestones.
- Milestone Funding: Use milestones to release funding, enabling portfolio controls to step in if project value looks to be at risk.
- Project Cadence: Keep focus on speed if you are targeting throughput as a KPI. Reclaim contingency for other projects wherever possible.
Gate 5: Closure & Benefits Realization
- Goal: Enforce discipline of lessons learned and track project through adoption to benefits, with a Benefits Tracker baked into Governance.
- Sponsorship: Confirm who in the business owns adoption and realised benefits after delivery, and who will track them. See how business ownership differs from PMO reporting.
- Demonstrate Value: Celebrate wins – results & cadence of project, positive impact of demand management approach.

Put simply, Stage Gates are the backbone of portfolio governance that should connect project selection through to a cycle of continuous improvement and ongoing narrative on benefits.
Stage Gates + Prioritization = Process
Stage Gates are ideal for implementing a prioritization process. Here’s why:
- Collect the data you need for review as part of a process, building muscle memory for how to score projects.
- Apply gating factors to filter out non-starters early.
- Create parallel flows through one “front door,” triaging to the right sub-portfolio, e.g.:
- Eisenhower matrix for urgency
- Mandatory model for “must-do” projects
- Light-touch route for low-value requests
- Apply tests for risk and value at the right points; quantifying both enables data-led decisions.
- Integrate resource availability into approvals to avoid over-commitment.
- Avoid approving projects on financials alone when no resources are available.
- Distinguish “Approved to Start” from “Approved (start later)”. Deferring a start can reduce simultaneous work and help teams finish existing commitments sooner. See why starting fewer projects can improve project flow.
In plain English, project prioritization is critical to portfolio success, and demand management is how prioritization is baked into your operating model.
Why Phasing Matters
Phased approvals let you keep control of projects without micro-managing every decision:
- Fund early research so you can right size your long-term pipeline.
- Explore innovation and R&D ideas without blowing the portfolio.
- Make informed go/no-go calls at each stage.
- Keep alert to spending and progress for Work in Progress: cutting back on “zombie” projects may be how you accelerate delivery for high value work.
- Reflect your R&D process into your governance structure so finance, PMO and innovation work together with shared Stage Gates.
The key is that projects are not simple entities. They have a defined start and end, but what happens between those points varies greatly.

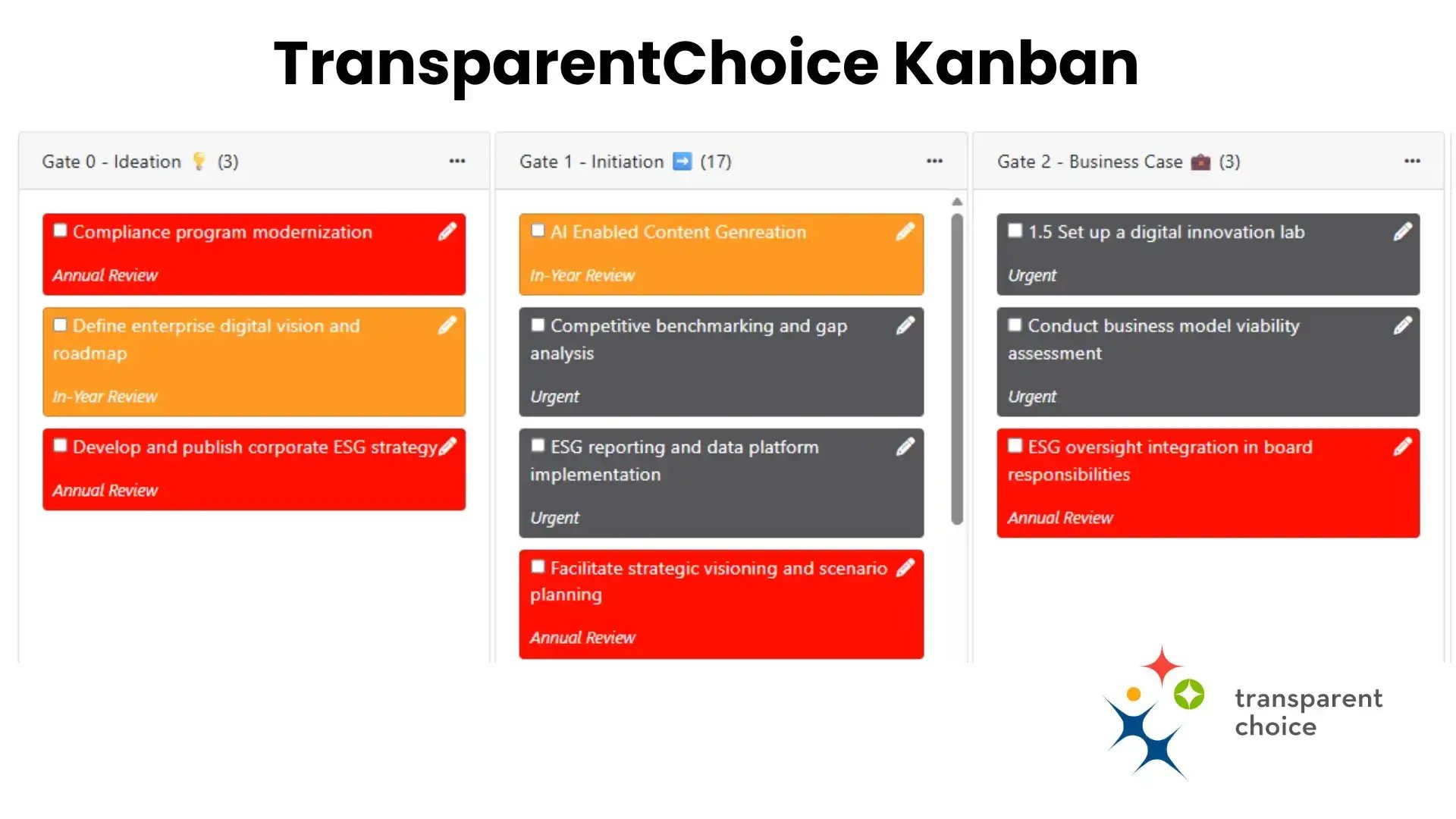

Governance = Trust and Speed via a Kanban
When you’re managing a portfolio of projects it’s important to have the rules of engagement clearly set out:
- Roles: Who owns each gate? (PMO, business sponsor, portfolio board).
- Criteria: Published and agreed upfront.
- Transparency: Document decisions and rationale.
- Streamline approvals: Workflow sign-off and notifications.
- Authority levels: Make clear who can decide at each level, and build those rules into stage-gates.
- There is a danger of acquiring the “template police” so don’t go overboard
Better still bake all this into software, so doing the right thing is also the easiest option. This is where a Portfolio Kanban board adds value as a single source of truth.
Business Case: Define Benefits Before You Start
The Business Case should be the “Golden Thread” that ties proposal to delivery to implementation. Use Stage Gates to develop it:
- Benefits defined upfront: owners, measures, baseline.
- Evidence over slides: structured data, not vague PPT promises.
- Accountability: Link benefits to selection criteria and post-initiation checkpoints.
- Evolve incrementally: The Business Case as a living document not a fixed hurdle.
Nobody expects the pre-approval business case to exactly reflect the end results; the point is that it should be the start of a journey and not just a one-time hurdle to get funded.
AI: Practical Help, Not Hype
AI can provide practical support for some elements of the stage-gating process. The structure of stage gates can make that support more focused, because different tasks become relevant as a proposal develops:
- De-duplicating and clustering ideas
- Flagging missing data and upcoming compliance milestones
- Drafting documents for different audiences
- Preparing information for prioritization
- Summarizing patterns in recorded outcomes
Stage Gates can also give AI a more structured context to work with, because proposals are being developed through defined steps with clearer information requirements.
Metrics That Matter
Building a stage-gate system will help a PMO define success metrics for their portfolio. For example:
- Gate cycle time: Speed of progress through stage gate - make “decision latency” a KPI.
- Portfolio mix: Project type by gate – link to strategic alignment and risk to see what’s coming.
- Benefits Realization: In Closure, capture the outcomes, tracking end results to business case as metric for successful delivery.
PMOs must be prepared to justify their existence. Being able to show what’s happening in a clear way is a great start but being able to then show how things are performing, improving and delivering benefits is a critical next step to this base.
When to Move Beyond Spreadsheets
Spreadsheets get harder to manage as volume, contributors and gates increase. Where the process also needs to connect prioritization with funding, capacity and other portfolio constraints, TransparentChoice software can support that process:
- Build Stage Gates into Portfolio Kanban, with stages appropriate to the portfolio.
- Implement structured prioritization using agreed criteria, including Analytic Hierarchy Process (AHP) where appropriate.
- Compare scenarios against funding and capacity limits before committing.
- Collaborate on Business Case submissions and team scoring.
- Streamline approvals and keep the record of decisions in one place.
- Make current status visible to stakeholders.
Some PMOs with smaller portfolios are fine in spreadsheets – the point is to recognise when your “free” solution is costing you more than the price of a fit-for-purpose solution.
FAQ: Stage Gates for Demand Management
1. What are stage gates in demand management?
Stage gates are structured checkpoints in the intake process where ideas are reviewed against agreed criteria before moving forward. They help control flow, enforce governance, and improve decision quality.
2. Why keep gates after project initiation?
Because business cases can erode over time. As Steve Jenner discusses in our Portfolio Management: Influencing the Weather? webinar, staged funding and continued review give leadership opportunities to revalidate benefits, challenge assumptions and reconsider what should proceed. But a project does not have to underperform for its next commitment to deserve review. If the business case still works but another credible claim now needs the same scarce resources, leadership may need to ask whether the existing investment should still be protected to the same extent.
3. How do stage gates and AHP work together?
Stage gates define when decisions happen; AHP provides a structured and transparent way to turn strategy into weighted criteria and project assessments.
4. Is prioritization just about funding?
No—prioritization also allocates scarce skills and capacity. A project with funding but no people won’t deliver value.
5. Why is ideation important?
Ideation is the bedrock of demand management. Easy access for frontline staff unlocks practical savings and customer service improvements that leadership might miss.
6. How does AI help in demand management?
AI can de-duplicate ideas, cluster themes, draft documentation for different audiences, and flag gaps in proposal information.
7. What’s the role of a portfolio Kanban?
Mapping stage gates to a Kanban board gives you a single visual view, supports WIP limits, and can make reporting and data collection easier to manage.
8. Why is a strong business case critical?
Because it defines benefits before you start, creating accountability and making the process data-driven rather than based on vague promises in PowerPoint.
9. What is phasing and why does it matter?
Phasing allows partial funding for research or feasibility studies before full approval. It’s essential for balancing short-term delivery with longer-term innovation and R&D initiatives.
10. How do I measure success?
Track throughput, conversion rates, lead time, and gate cycle time (decision speed). Make “decision latency” a PMO KPI. Also monitor portfolio mix—BAU vs strategic vs R&D.
💚 If you enjoyed this article, please consider following us. It’s a small gesture that means a lot to us and encourages us to keep sharing what we learn. See the ways to follow us below ↓
